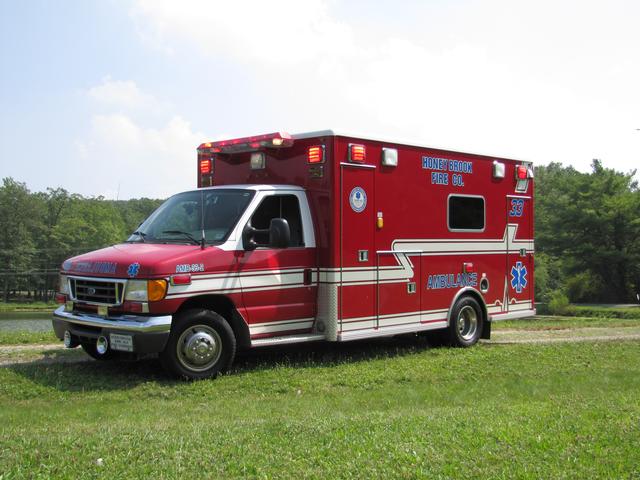

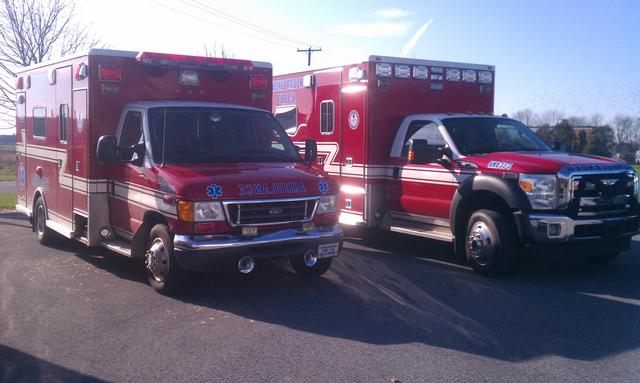

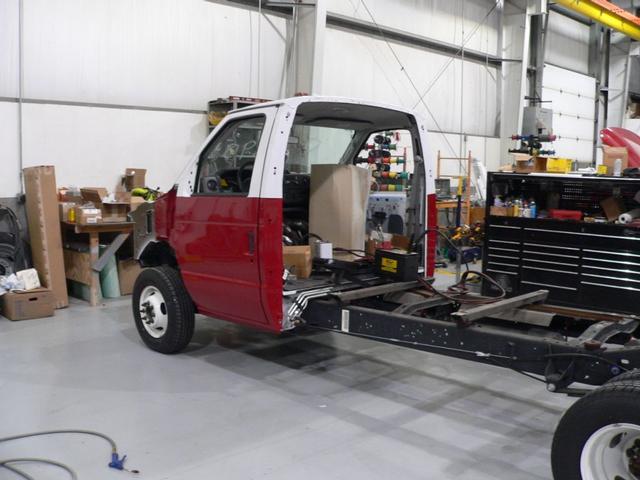

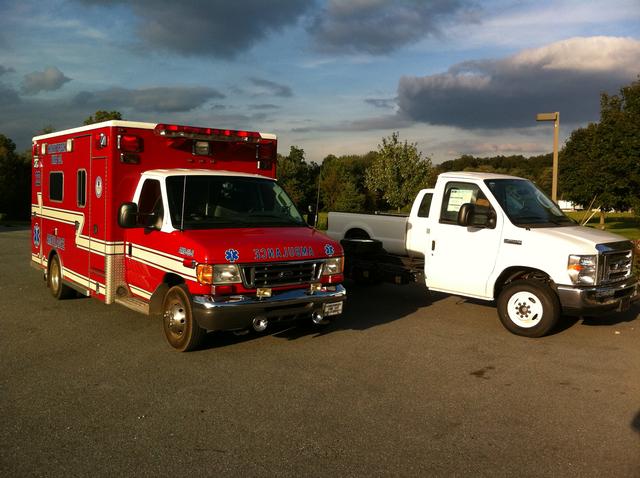

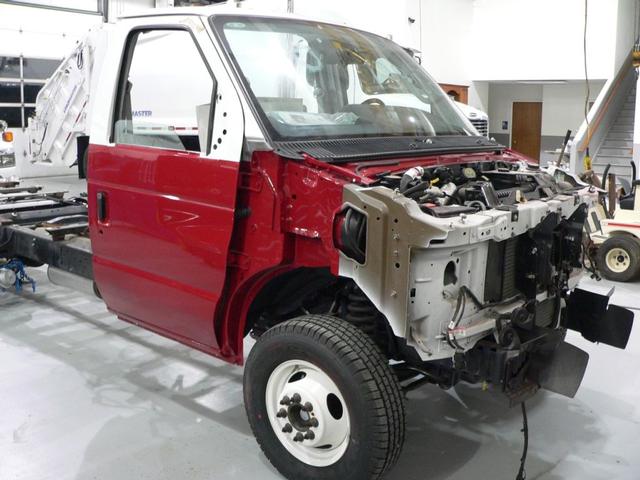

Ambulance 33-2 & Ambulance 33-3 together for the last time before the re-chassis.
|
|
| |

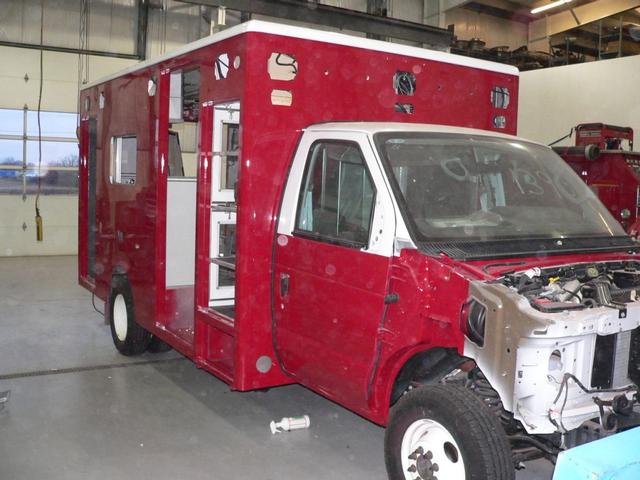

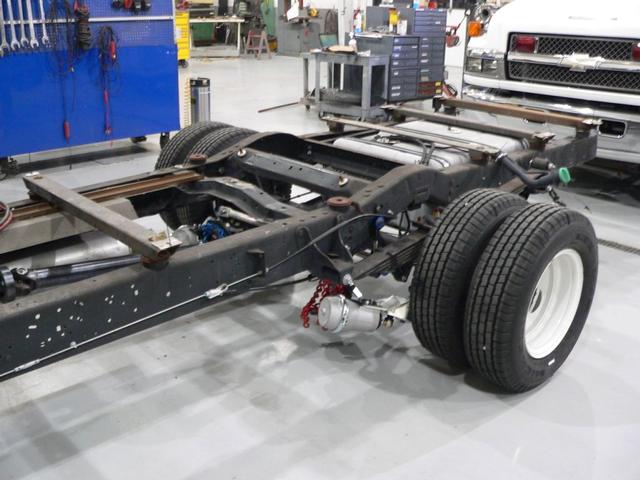

Ambulance 33-2 next to it's new chassis
|
|
| |
|
|
| |

Progress as of 12/16/11 - New Chassis Painted
|
|
| |
Progress as of 12/16/11 - On-Spot chains installed
|
|
| |
Progress as of 12/16/11 - Wiring and electrical system install in new chassis.
|
|
| |

Progress as of 12/16/11
|
|
| |
Progress as of 12/16/11
|
|
| |

Progress as of 12/16/11 - Lettering and doors removed for painting
|
|
| |

Progress as of 12/16/11 - Box removed from old chassis
|
|
| |

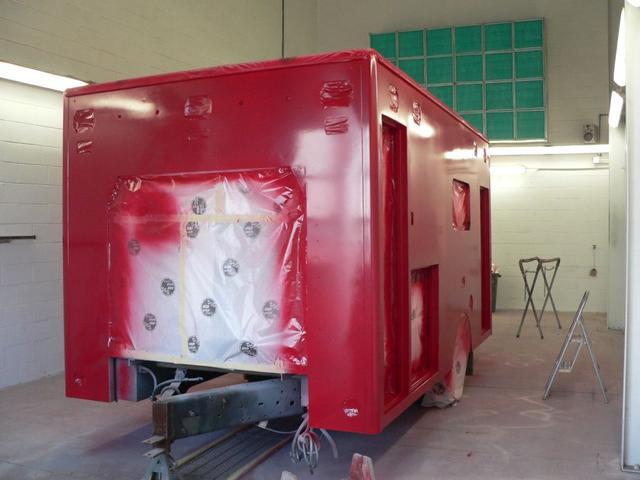

Progress as of 1/6/2012. Box is primed and ready to be painted.
|
|
| |

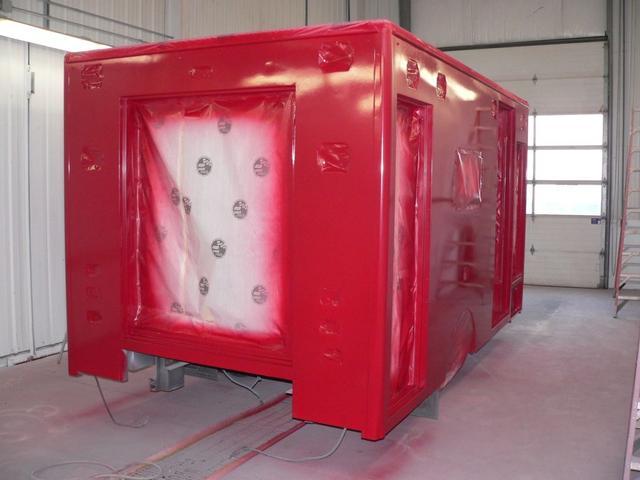

Progress as of 1/13/2012. Painting of the box complete.
|
|
| |
Progress as of 1/13/2012. Painting of the box complete.
|
|
| |
Progress as of 1/13/2012. Painting of the box complete.
|
|
| |
Progress as of 1/13/2012. Painting of the box complete.
|
|
| |
Progress as of 1/13/2012. Painting of the box complete.
|
|
| |
Progress as of 1/13/2012. Painting of the box complete.
|
|
| |

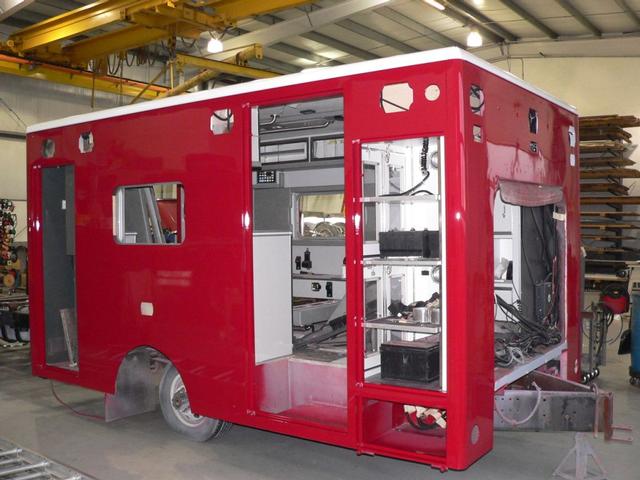

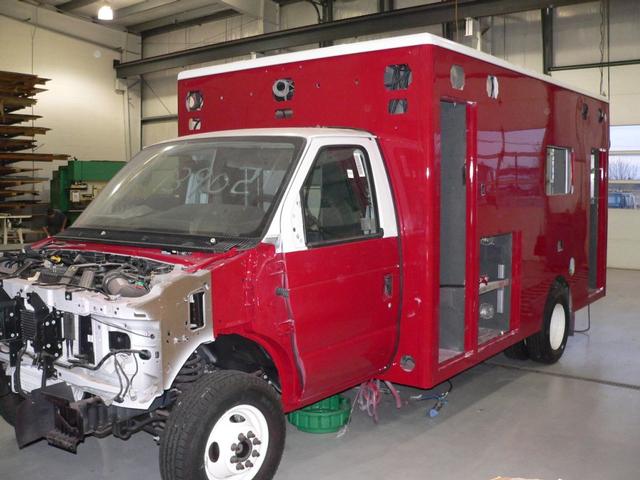

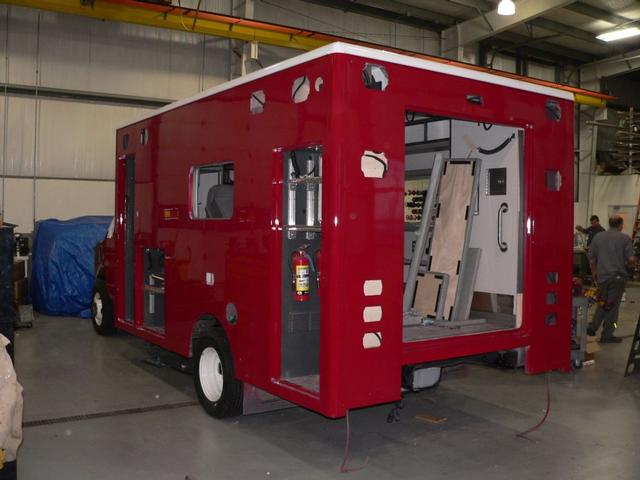

Progress as of 1/20/2012. Box mounted on new chassis.
|
|
| |
Progress as of 1/20/2012. Box mounted on new chassis.
|
|
| |
Progress as of 1/20/2012. Box mounted on new chassis.
|
|
| |
Progress as of 1/20/2012. Box mounted on new chassis.
|
|
| |

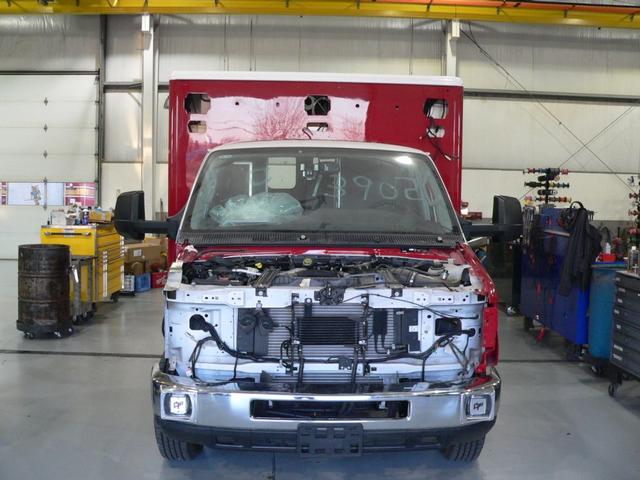

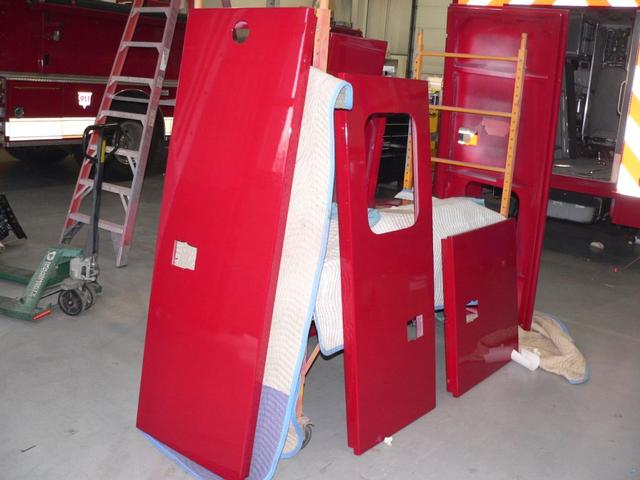

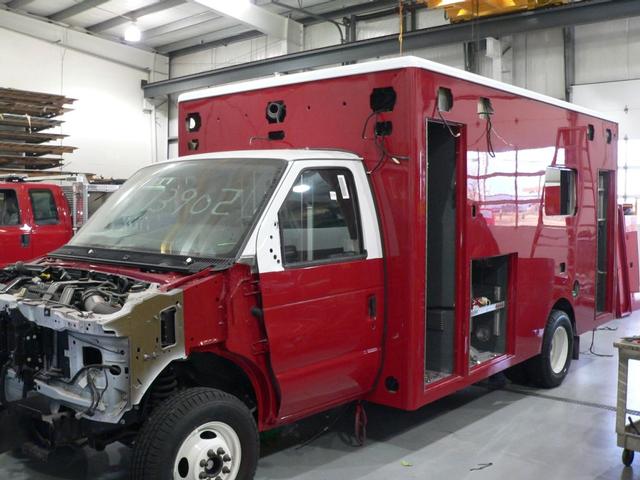

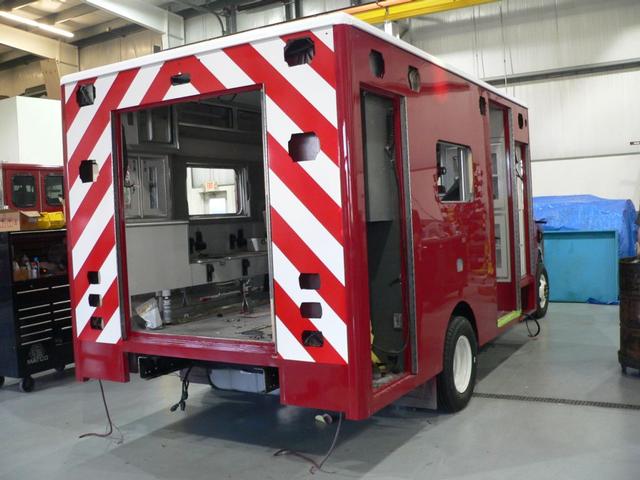

Progress as of 1/27/12 - Wiring for emergency lighting in progress, compartment doors painted, new dual backup/patient compartment camera installed and striping/lettering in progress.
|
|
| |
Progress as of 1/27/12 - Wiring for emergency lighting in progress, compartment doors painted, new dual backup/patient compartment camera installed and striping/lettering in progress.
|
|
| |
Progress as of 1/27/12 - Wiring for emergency lighting in progress, compartment doors painted, new dual backup/patient compartment camera installed and striping/lettering in progress.
|
|
| |
Progress as of 1/27/12 - Wiring for emergency lighting in progress, compartment doors painted, new dual backup/patient compartment camera installed and striping/lettering in progress.
|
|
| |
Progress as of 1/27/12 - Wiring for emergency lighting in progress, compartment doors painted, new dual backup/patient compartment camera installed and striping/lettering in progress.
|
|
| |

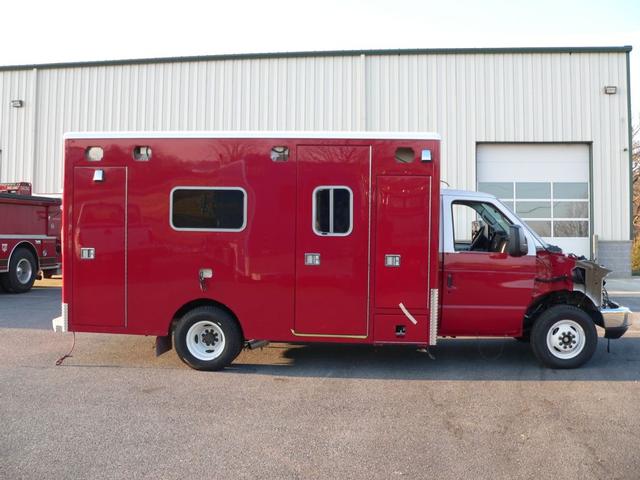

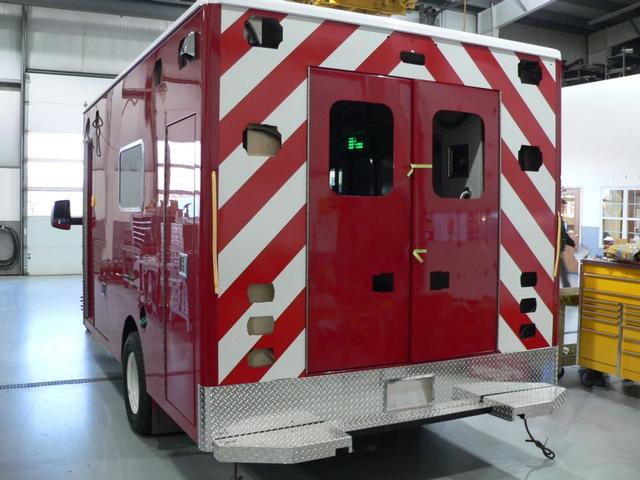

Progress as of 2/3/12 - Compartment doors mounted, electrical wiring almost complete, Striping/Lettering continues, Diamond plate steps being installed.
|
|
| |
Progress as of 2/3/12 - Compartment doors mounted, electrical wiring almost complete, Striping/Lettering continues, Diamond plate steps being installed.
|
|
| |
Progress as of 2/3/12 - Compartment doors mounted, electrical wiring almost complete, Striping/Lettering continues, Diamond plate steps being installed.
|
|
| |
Progress as of 2/3/12 - Compartment doors mounted, electrical wiring almost complete, Striping/Lettering continues, Diamond plate steps being installed.
|
|
| |

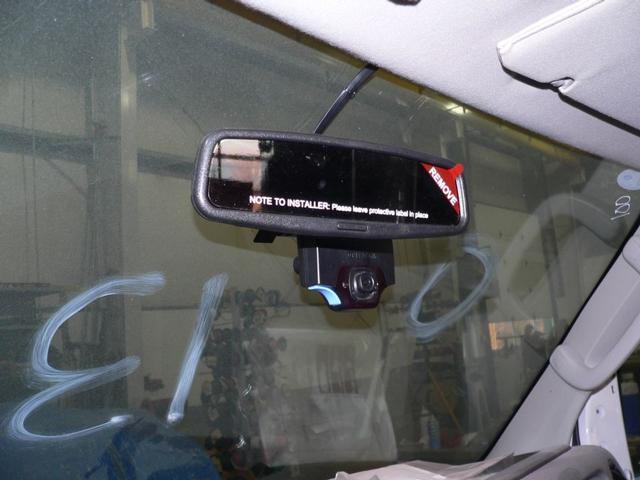

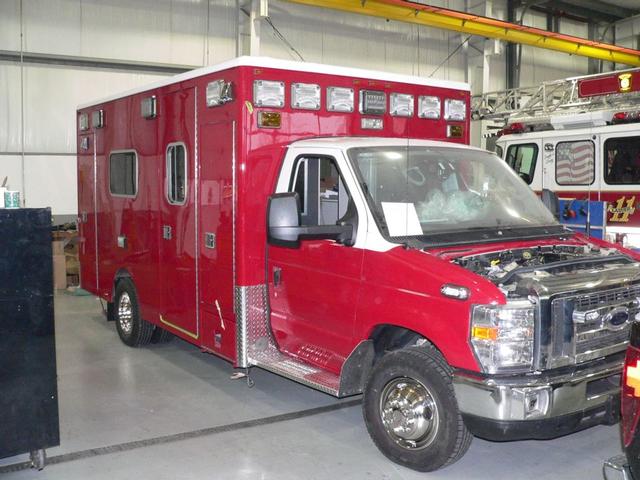

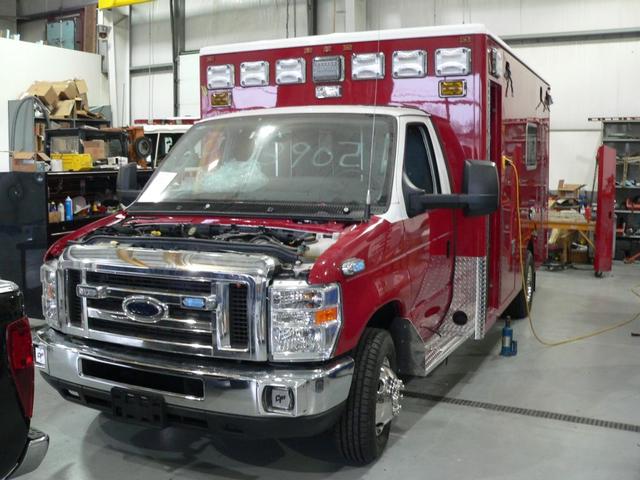

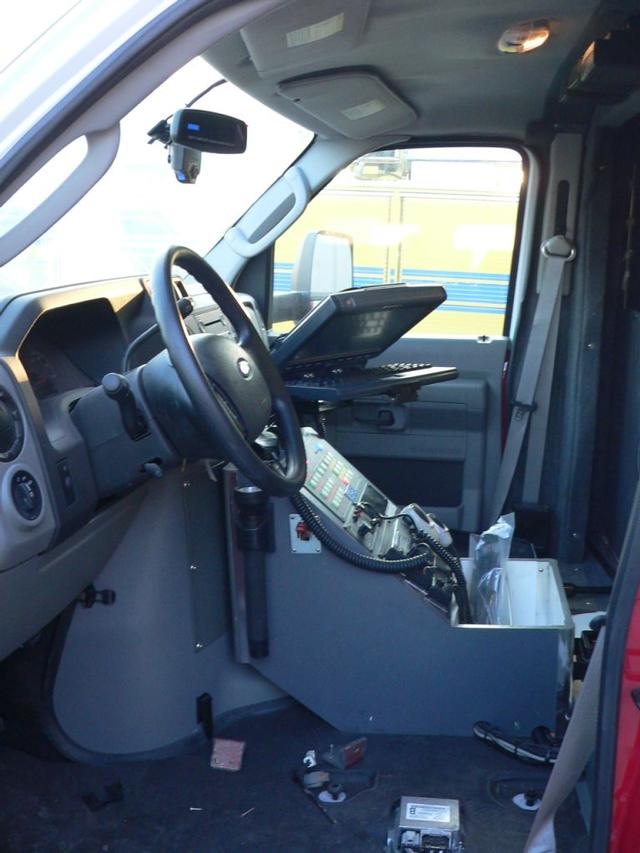

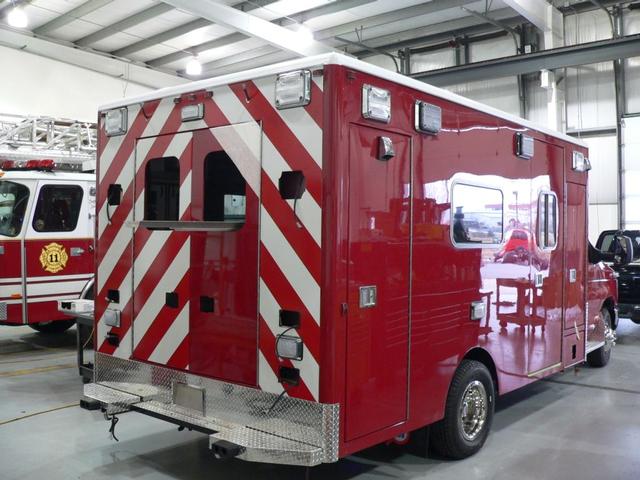

Progress as of 2/10/12 - Emergency and scene lighting in progress. Center console, radios and computer mounted.
|
|
| |
Progress as of 2/10/12 - Emergency and scene lighting in progress. Center console, radios and computer mounted.
|
|
| |
Progress as of 2/10/12 - Emergency and scene lighting in progress. Center console, radios and computer mounted.
|
|
| |
Progress as of 2/10/12 - Emergency and scene lighting in progress. Center console, radios and computer mounted.
|
|
| |

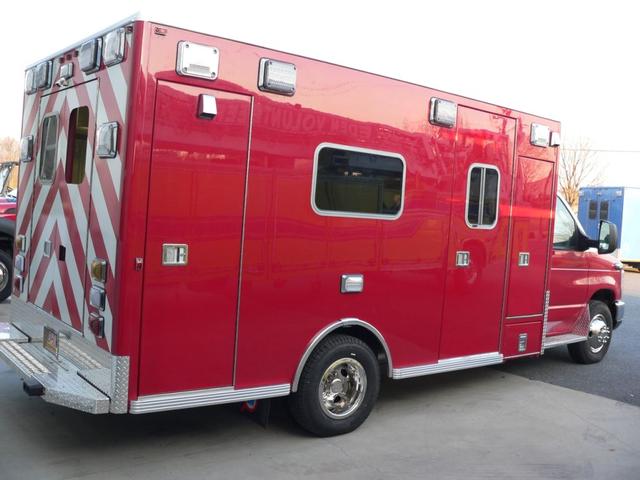

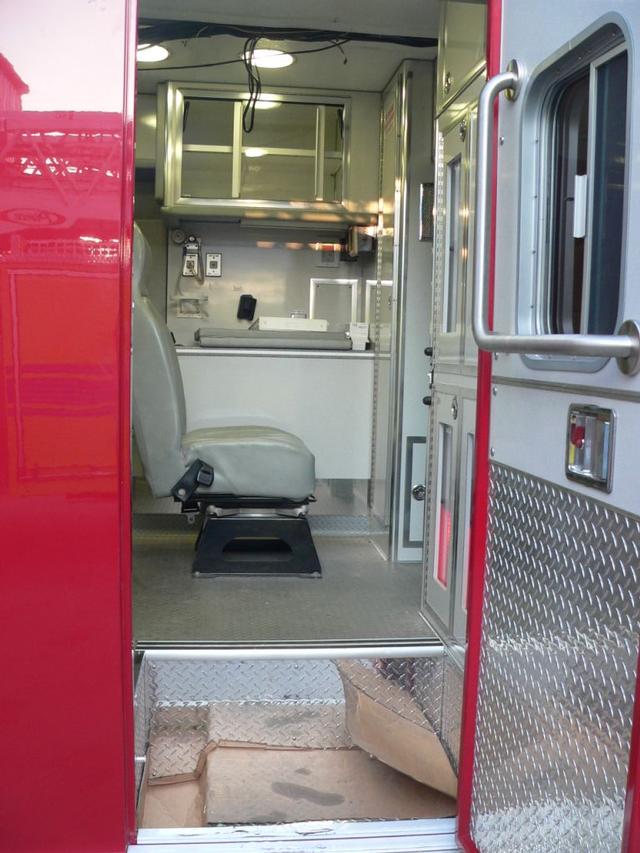

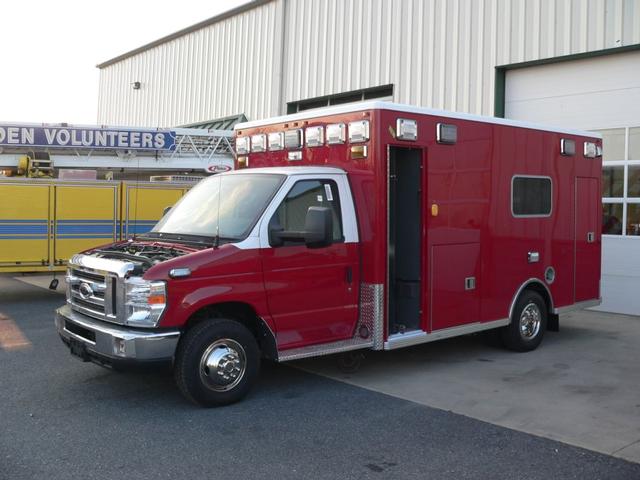

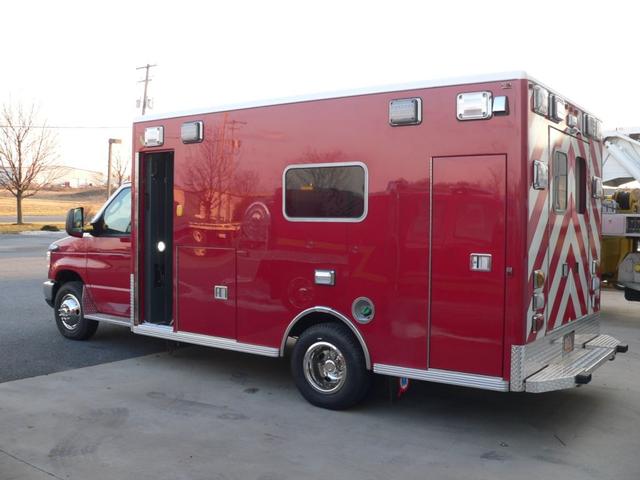

Progress as of 2/17/2012. Final touches! Lettering to be finished this upcoming week.
|
|
| |
Progress as of 2/17/2012. Final touches! Lettering to be finished this upcoming week.
|
|
| |
Progress as of 2/17/2012. Final touches! Lettering to be finished this upcoming week.
|
|
| |
Progress as of 2/17/2012. Final touches! Lettering to be finished this upcoming week.
|
|
| |
Progress as of 2/17/2012. Final touches! Lettering to be finished this upcoming week.
|
|
| |

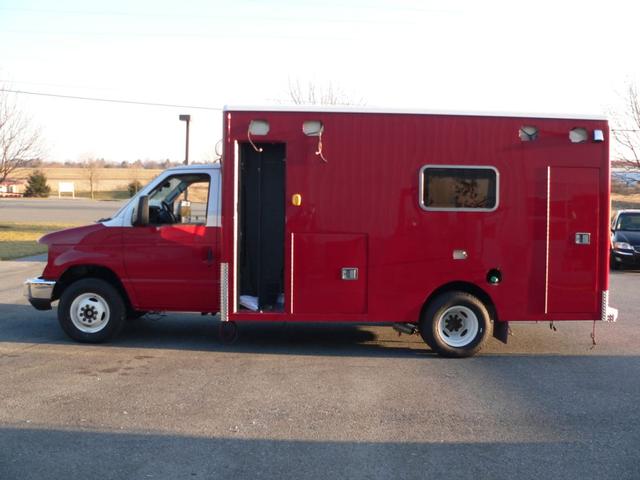

Progress as of 2/17/2012. Final touches! Lettering to be finished this upcoming week.
|
|
| |
